Sampling is where a case specification stops being a drawing and becomes an object. It is also the last stage at which changing your mind is cheap, which makes it the stage worth the most attention per hour spent.

The stages, and what each one is for

StageWhat it producesWhat it is actually testing
3D data reviewAgreed geometry and tolerancesWhether the design can be made at all, and at what tooling cost
Prototype shellMachined or printed partFit against real equipment, ergonomics, stacking
First shot from toolParts in production materialMould correctness - fill, warp, sink, latch engagement
Foam fit trialCavity in production foamWhether the cavity holds the equipment under shake and drop
Approval sampleSigned reference partFull specification compliance, including colour and print
Production validationParts from a normal production runWhether the process repeats the approval sample at speed

Each stage exists because the next one is more expensive to iterate. A geometry problem found at 3D review costs an edit; the same problem found at first shot costs a tool modification.

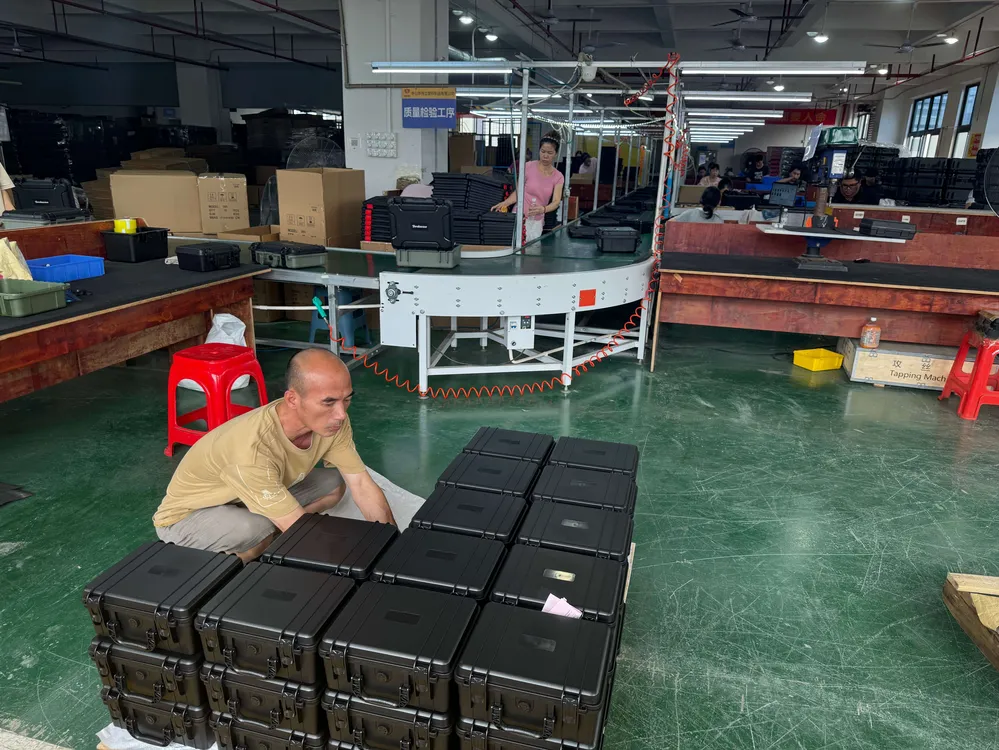

Sample assembly and sign-off in the production line
First article, pre-production sample and mass production each run the same sign-off form.

What to check on a first-shot sample

Work through the sample in a fixed order so that nothing depends on memory. The order below runs from the things that are hardest to change to the things that are easiest.

  1. Structure and geometry. Wall thickness consistency, absence of sink marks on visible surfaces, warp when the lid rests on a flat surface, and flushness of the lid-to-base seam.
  2. Seal and closure. Gasket seated evenly in its groove with no twist or gap, latches engaging fully, and the lid not rocking when closed.
  3. Latch cycling. Open and close every latch at least twenty times. Latches that feel stiff or gritty now will not improve in production.
  4. Foam fit. Insert the real equipment with its real cables. Shake the closed case gently and listen. The equipment should not move.
  5. Hardware and fittings. Handle return, wheel rotation if fitted, hinge smoothness, and the security of every fastener.
  6. Finish and colour. Under agreed lighting, against the reference chip, checking both shell and any painted or printed area.
  7. Print and marking. Position, size and adhesion against the drawing. Tape-test adhesion on a sample you are willing to sacrifice.
  8. Documentation. Dimensional report, and where applicable, the test report that corresponds to this specific sample.
Sample assembly and sign-off in the production line

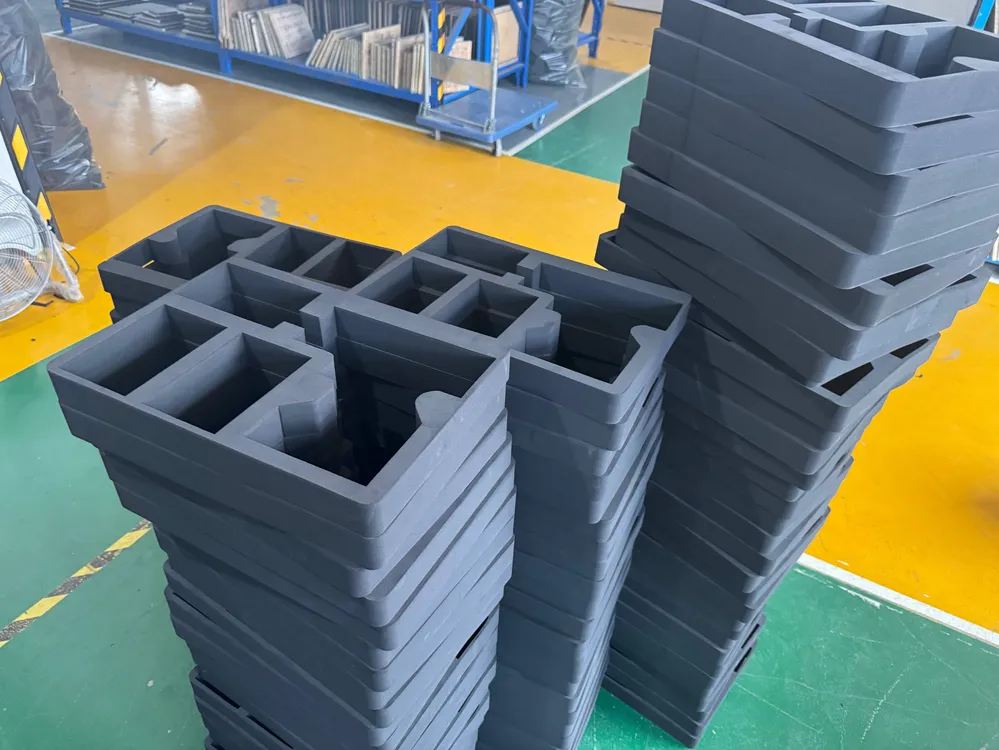

The first foam cut is the last on-site decision between cavity and product.
Test the sample you intend to keep, and keep the sample you tested. A golden sample that has never been opened, dropped or cycled is not a reference - it is a display piece.

Running a foam fit test properly

Foam fit is the most common cause of a second sampling round, and the reason is almost always that the test used a stand-in rather than the real thing. A foam cavity cut to a drawing will hold a drawing; it may not hold the actual device with its cable, its protruding connector or its aftermarket accessory.

  • Supply the real equipment, or a mass-and-dimension-accurate dummy, before foam is cut.
  • Include every item that ships in the case - cables, chargers, spare parts, documents.
  • Specify the orientation the user will actually open the case in, and confirm nothing falls out when it is opened.
  • Shake test: hold the closed case and shake in all three axes. Movement means the cavity is too large or too shallow.
  • If the contents are heavy, check that the foam is not bottoming out - the cavity base must not be the load path.

Writing a sign-off that protects both sides

A good approval record is not a formality; it is the document that ends arguments before they start. It should be short, specific and photographic.

  • Identify the sample precisely - part number, revision, date, and the drawing revision it was built to.
  • Photograph the approved part from fixed angles, including close-ups of texture, print and hardware.
  • State the tolerances and colour limit in numbers, not adjectives.
  • List any accepted imperfection explicitly, with a photograph, so it cannot later be raised as a defect.
  • List anything explicitly not approved, with the required correction.
  • Record where retained samples are held by each party, and for how long.
  • Name the approver and the date.

None of this requires the buyer and factory to distrust each other. It requires them to have the same memory, which no one does after six months and three production runs. For a JUNZHIJIA programme the sampling sequence, the number of rounds, and the tests performed on each round are agreed at the start of the project, because they depend on whether the shell is a stock size, a modified stock size, or a new tool.
